Thursday, 9 July 2026 MUMBAI EDITION LIVE

Vadape-Thane Highway Expansion Nears Completion

92% work complete, to ease congestion on Mumbai-Nashik corridor

Mumbai Alert · City Desk
Mumbai Alert · City Desk
City Desk · Mumbai Alert News · Wed, 08 July 2026 at 04:06 am
Vadape-Thane Highway Expansion Nears Completion

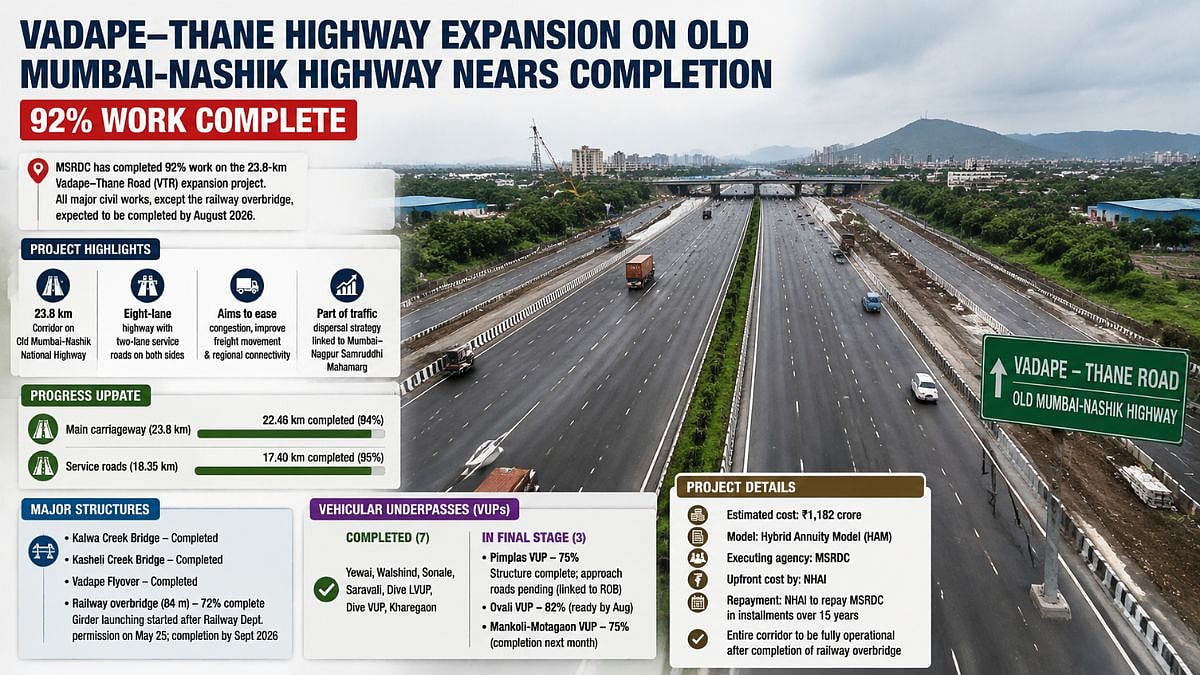

The Maharashtra State Road Development Corporation (MSRDC) has made significant progress on the Vadape–Thane Road expansion project, with 92% of the work completed. The project, which aims to ease chronic congestion on the Old Mumbai-Nashik National Highway, is expected to be fully operational by the end of the year.

The 23.8-km highway expansion project is being executed on one of the busiest freight and commuter corridors connecting Thane, Bhiwandi, and Nashik. Once completed, the highway will be widened into an eight-lane corridor with two-lane service roads on both sides, significantly improving traffic flow, particularly for heavy commercial vehicles accessing Bhiwandi's warehouse hub.

According to the latest progress report, 22.46 km of the 23.8-km main carriageway has been completed, along with 17.40 km of the 18.35-km service roads. Three major bridges, including the Kalwa Creek Bridge, Kasheli Creek Bridge, and the Vadape Flyover, have been completed. The construction of the 84-metre railway overbridge, which is the only major pending structure, has reached 72% completion, with girder launching begun after the Railway Department granted permission on May 25.

The project also includes 10 vehicular underpasses designed to eliminate traffic bottlenecks and improve local connectivity. Seven underpasses have already been completed, while the remaining three are in the final stages. The Pimplas VUP has achieved 75% progress, the Ovali VUP has reached 82% completion, and the Mankoli-Motagaon VUP stands at 75% completion.

The Vadape–Thane expansion project is expected to improve connectivity between Thane, Bhiwandi, and Nashik, while reducing travel delays caused by increasing freight movement and industrial traffic in the region. The project is being executed at an estimated cost of around Rs 1,182 crore under the Hybrid Annuity Model (HAM). The National Highways Authority of India (NHAI) will bear the upfront cost of the project and repay MSRDC in instalments over a 15-year period, ensuring a sustainable financial framework.

The completion of the Vadape–Thane highway expansion project will have a significant impact on the regional economy, as it will improve the movement of goods and people, reducing congestion and travel times. The project is also expected to boost the growth of industries in the region, particularly in Bhiwandi, which is a major warehouse hub.

In the coming months, the focus will be on completing the remaining work, including the construction of the railway overbridge and the remaining underpasses. The project is expected to be fully operational by the end of the year, bringing much-needed relief to commuters and industries in the region.

The Vadape–Thane highway expansion project is an important part of the traffic dispersal strategy linked to the Mumbai–Nagpur Samruddhi Mahamarg, and its completion will have a significant impact on the regional economy. The project's completion will also demonstrate the government's commitment to improving the region's infrastructure, which is critical for the growth and development of the economy.

As the project nears completion, officials are confident that it will bring significant benefits to the region, including improved connectivity, reduced travel times, and increased economic growth. The project's completion will also set an example for other infrastructure projects in the region, demonstrating the importance of investing in infrastructure to drive economic growth and development.

In conclusion, the Vadape–Thane highway expansion project is a critical infrastructure project that will have a significant impact on the regional economy. The project's completion will bring much-needed relief to commuters and industries in the region, and will demonstrate the government's commitment to improving the region's infrastructure. With the project nearing completion, officials are confident that it will bring significant benefits to the region, including improved connectivity, reduced travel times, and increased economic growth.
